Contact with the wharf by Big Glory

A limited-scope, fact-gathering investigation into this occurrence was conducted in order to produce this short summary report and allow for greater industry awareness of potential safety issues and possible safety actions.

What happened

At 0706[1] on 20 November 2014, two port pilots boarded Big Glory (cover) off Cape Flattery (Figure 1), where the ship was to berth for loading silica sand.[2] The pilot assigned to the pilotage task was very experienced and had performed about 70 pilotages into the port, including about 15 on Big Glory. As he was returning after 6 months leave, procedures required that he undergo a check pilotage.

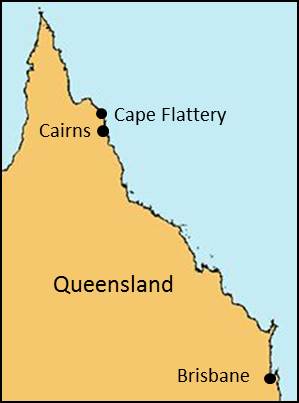

Figure 1: Cape Flattery

Cape Flattery
Source: ATSB

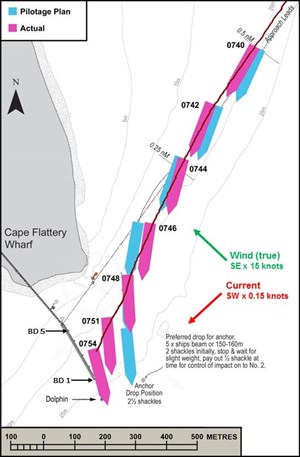

Figure 2: Big Glory’s planned and actual positions

MO-2014-014_fig2
Source: Maritime Safety Queensland with ATSB annotations

Once on the ship’s navigation bridge, the pilot exchanged information with the master and discussed the pilotage plan (Figure 2). The pilot advised that the current in the area was flowing northeast[3]  at 0.2 knots[4] and high tide was at 0755. The wind at the time was from the southeast at 15 knots. The master confirmed that all the ship’s equipment, including the main engine, was in order. The officer of the watch and the seaman steering the ship were the other members of the bridge team.

At 0715, the pilot took over the conduct of Big Glory with the check pilot observing. He manoeuvred the ship onto the line of the approach leads using visual cues and the ship’s radar while progressively reducing its speed.

By 0740, the ship was positioned along the line of the approach leads about five ship lengths (about 1 km) from the wharf (Figure 2). Its speed was about 3.4 knots and decreasing with the main engine stopped. The pilot established radio contact with the loading supervisor on the wharf and asked him to report as the ship’s bow passed each breasting dolphin (BD) there. [5]

At 0744½, the ship’s speed had decreased to about 2.6 knots and the main engine was run dead slow ahead. Two work boats also arrived near the ship to assist, mainly to assist running mooring ropes when berthing. The port has no tugs and the workboats have limited tug ability.[6]

By 0746½, Big Glory’s speed had increased to about 3.5 knots. The main engine was stopped and then run dead slow astern. The pilot felt that the ship’s speed was not decreasing as expected and he was concerned the ship would overshoot the planned anchor let go position. Hence, main engine power was progressively increased, including about 30 seconds at full astern.

At 0749, the main engine was stopped and the ship was no longer moving ahead. At about this time, the wharf supervisor reported to the pilot that the bow was in line with BD1 (Figure 2). The pilot asked the master to have the crew standby to let go the port anchor.

At this stage, the pilot observed Big Glory being ‘rapidly set on to the wharf’ and considered aborting the berthing. He decided against aborting because he was certain that the ship’s ‘stern would make substantial contact with the wharf’.

A few seconds after 0749, the main engine was run ahead in an attempt to gain headway and manoeuvre Big Glory to the planned anchor let go position some 150 m ahead. The engine was run ahead at up to half power until shortly before 0751, when it was stopped. The ship’s bow was now about 60 m from the wharf and about 100 m away from the planned anchor let go position.

At 0751, the pilot asked for the port anchor to be let go and held on to with two shackles[7] on deck. The main engine was ordered astern and power progressively increased to full astern before it was stopped shortly after 0752. The ship’s headway reduced as it moved towards the wharf.

At about 0754, Big Glory made contact with the dolphin (Figures 2 and 4). The ship’s hull, at the aft end of number one cargo hold, was damaged about 1.5 m above the ballast water line. The shell plating was set-in in two locations about 1 m apart (Figure 3). Part of a steel bracket on the dolphin penetrated the plating leaving a hole about 180 mm x 60 mm. The bracket was partially torn off and the deck plating on the dolphin was dislodged (Figure 4).

Figure 3: Damage to the ship’s hull

ATSB marine occurrence MO-2014-014Source: Maritime Safety Queensland

Figure 4: Damage to the dolphin

ATSB marine occurrence MO-2014-014Source: Maritime Safety Queensland

Shortly afterwards, the wharf supervisor asked the pilot to move the ship clear of the wharf to allow an inspection of the damage to the dolphin. At 0756, the pilot began manoeuvring the ship off the wharf using the workboat forward to push on the starboard bow while heaving the anchor.

At 0810, Big Glory was clear of the wharf. The pilot handed over conduct of the ship to the check pilot and the ship was moved to a safe location within port limits.

At 1306, after some minor repairs to the dolphin were complete, the check pilot started manoeuvring the ship back to the berth. By 1420, the ship was all fast alongside the wharf.

On 25 November, temporary repairs to Big Glory’s hull to allow it to sail on the next voyage were completed. Subsequently, the ship loaded its cargo.

Maritime Safety Queensland investigation

Maritime Safety Queensland (MSQ), the regulatory agency responsible for pilotage at Cape Flattery, conducted an internal investigation into the incident that concluded that the pilot’s loss of situational awareness and error of judgment were the main contributing factors to the incident.

ATSB comment

As Big Glory approached the planned anchor let go position, astern propulsion was used for 90 seconds because the pilot felt that the ship’s speed was not decreasing. However, its speed was decreasing, and the ship stopped 150 m short of the anchor let go position. Ahead propulsion was then used for 90 seconds before the port anchor was let go in a position much closer to the wharf than planned (60 m instead of 150-160 m). The particular combination of the ships’ main engine and rudder movements in the prevailing wind and current resulted in a lateral movement (to starboard) towards the wharf. The use of two shackles of anchor cable as planned suggests that adjusting anchor/cable use to recover from the uncontrolled situation was not considered. Subsequently, the ship’s hull contacted the mooring dolphin with sufficient force to damage its shell plating and the dolphin. The pilot’s perception of the ship’s movement during the critical stages of the approach to the wharf is indicative of his situational awareness at the time.

Safety action

Whether or not the ATSB identifies safety issues in the course of an investigation, relevant organisations may proactively initiate safety action in order to reduce their safety risk. The ATSB has been advised of the following proactive safety action in response to this occurrence.

Maritime Safety Queensland

As a result of its investigation, MSQ’s safety action included the following recommendations:

Pilotage procedures

  • A review of the Cape Flattery pilotage plan to include an ‘abort’ position and a more accurate track to the ‘anchor position’.
  • Portable pilotage unit (PPU) usage to be made compulsory for all Cape Flattery berthings.
  • A requirement for pilots returning from leave exceeding 4 months to complete at least three mentored trips (inward) before undergoing a check pilotage.

Safety message

Bridge resource management (BRM) is critical to safely managing risks in a pilotage. Key elements of BRM include proper planning, execution and monitoring using all available resources. The use of electronic aids to navigation to support traditional methods of pilotage and navigation can significantly enhance the position monitoring ability and situational awareness of the bridge team and, thus, reduce the risk of an incident.
